Updates on Triumph’s Inspirations Expansion

Exterior rendering highlighting the structures and design of the new Inspirations Building. Subject to change.
For 10 years Triumph has operated Inspirations and has served over 1,900 women in substance use disorder treatment and transitional housing from this location. The last of Inspirations’ clients graduated in December of 2023 to prepare to temporarily close for renovation. This project increases treatment beds in Washington State for co-occurring disorders (substance use disorder and mental health conditions) and will support more women, their children, and their families for several years to come. The first phase of the project will double the number of beds available from 16 to 32 in 2025. The full project includes a second phase that, once fully funded, will complete the expansion to 48 total beds.

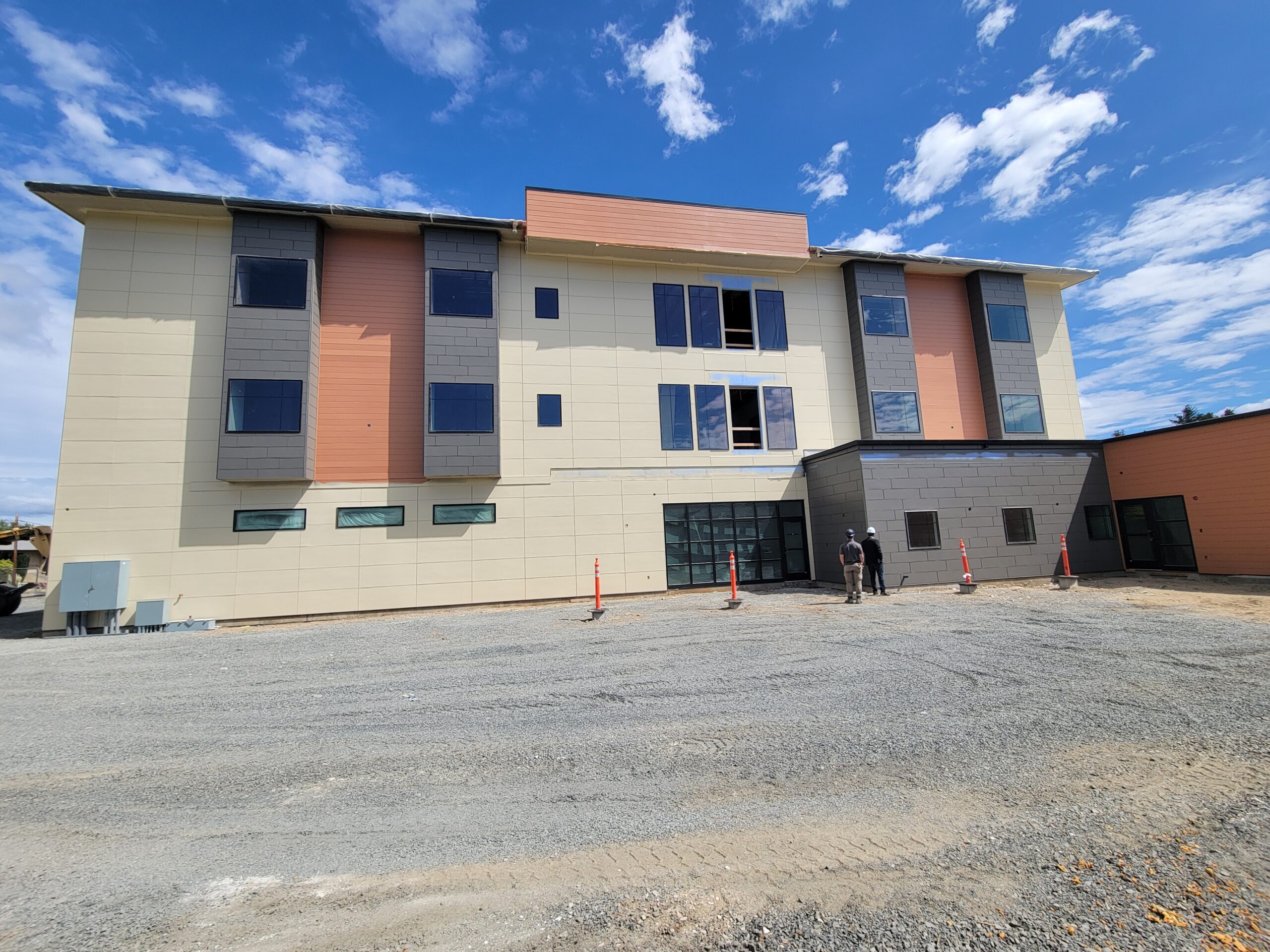

July 1st 2025,

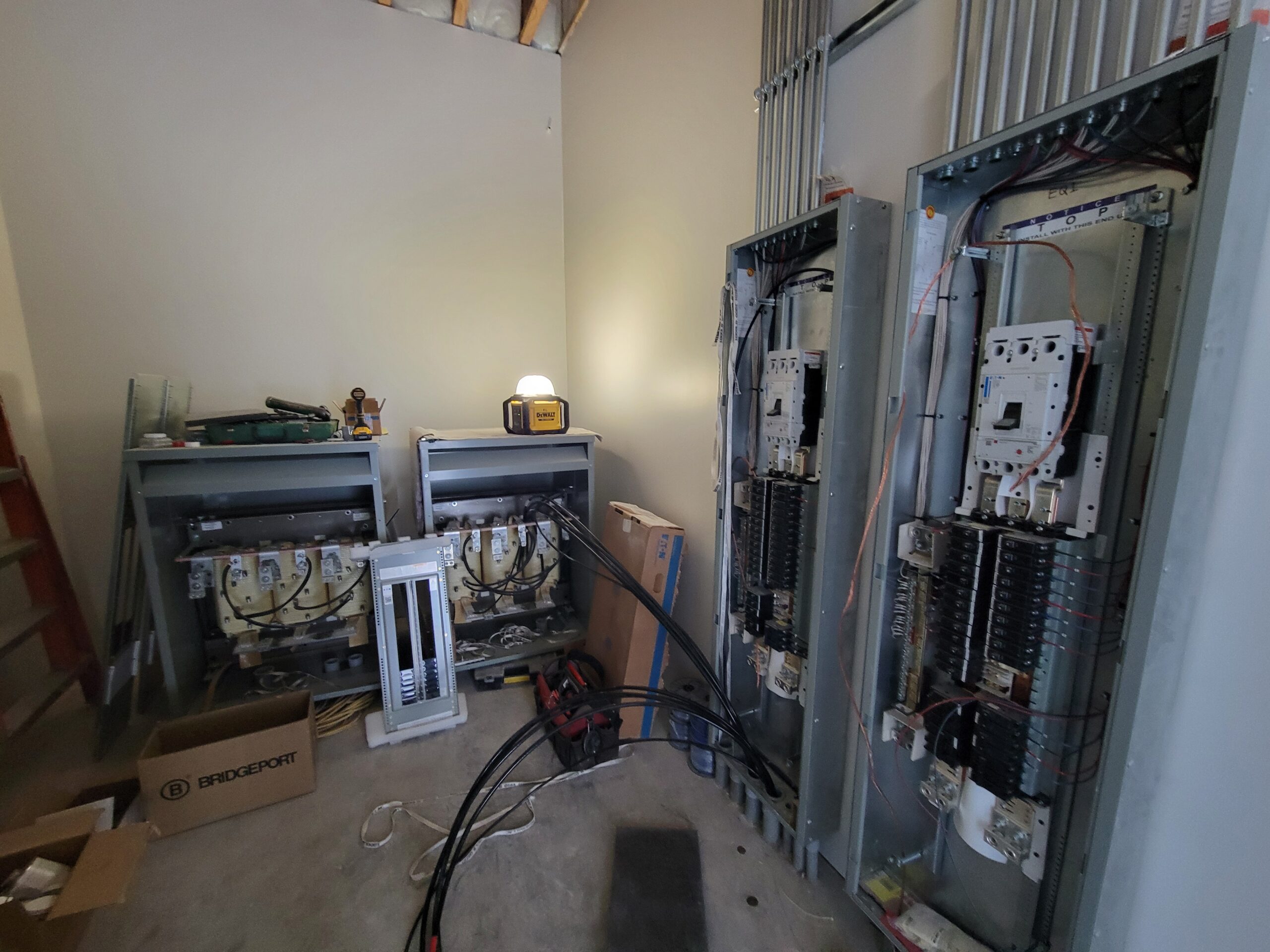

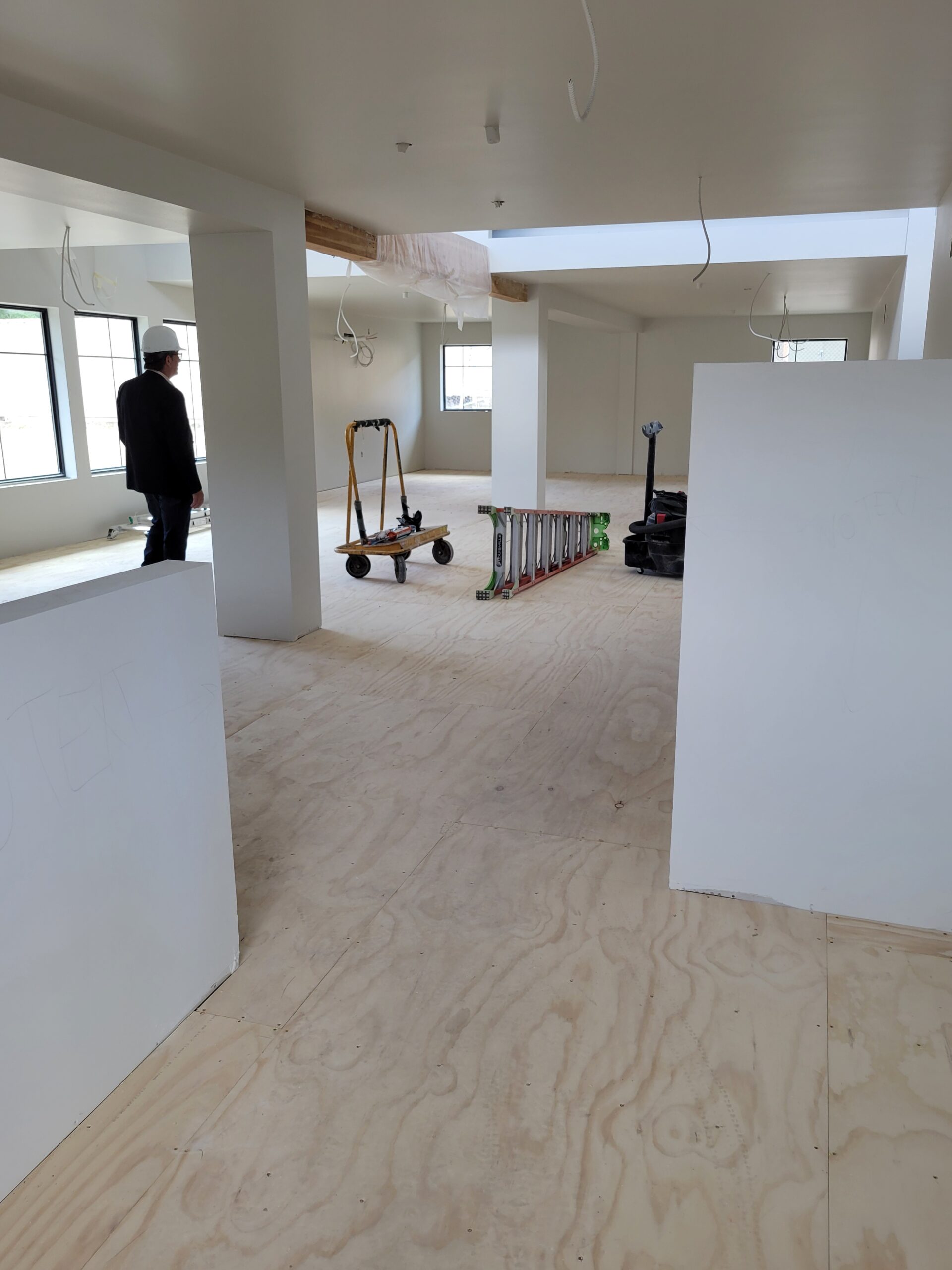

Inspirations construction continues to move forward on track. Work has been focused on exterior painting, interior paint and texture, and construction of the main entry vestibule and electrical room. Securitization has been completed for the $2.5 million Department of Commerce grant which will help with site work finalization for the 32-bed facility.
June 1st 2025,

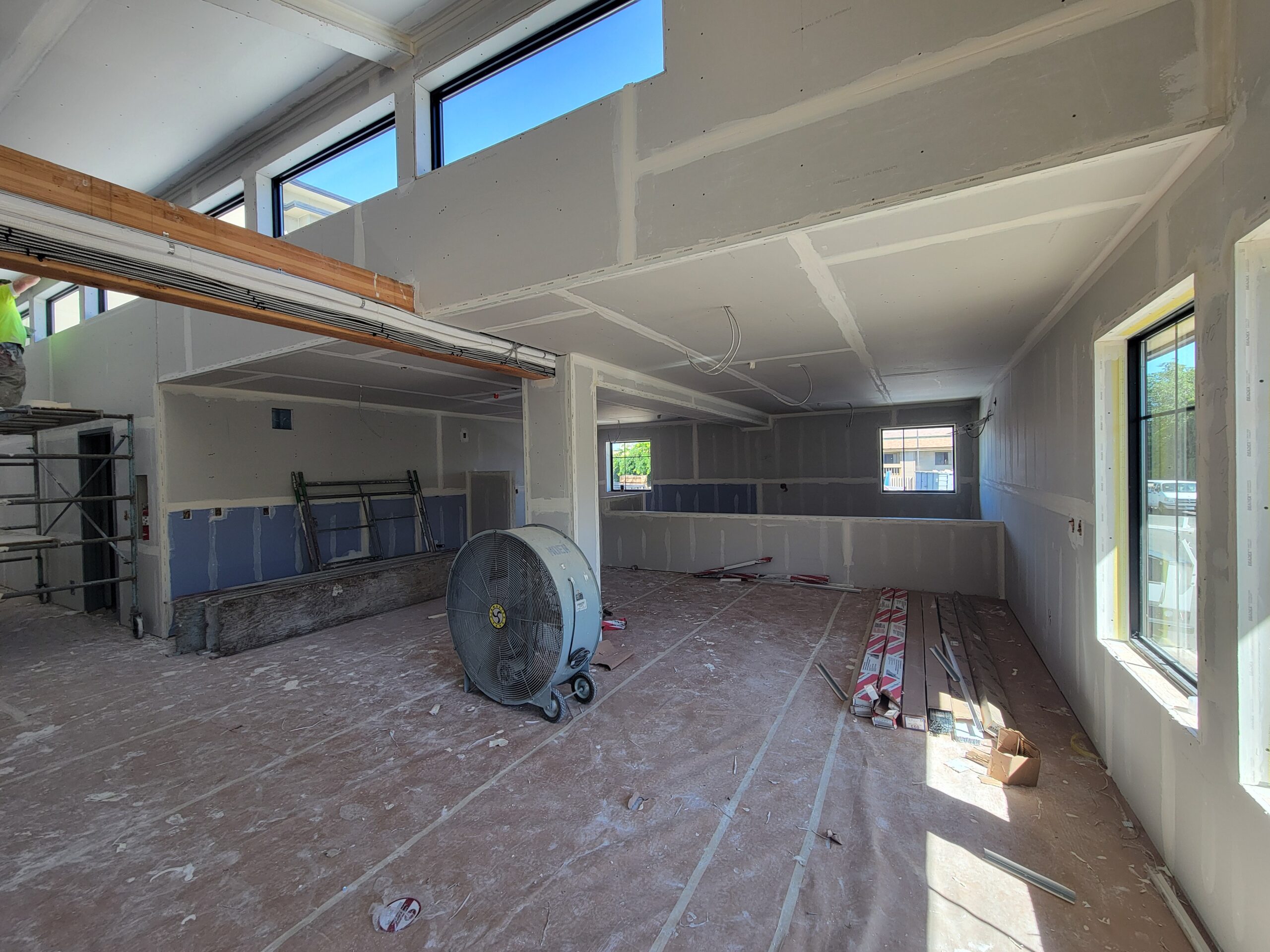

Work at the Inspirations building has been moving along rapidly with cooperative weather and a significant number of trades on-site executing on their respective tasks. Pictures shown include the finished siding from the North of the building which allowed the scaffold to come down and continued drywall work which has moved onto the second floor. Final design of the finishes for the building interior continue to be worked on.
May 22nd 2025,

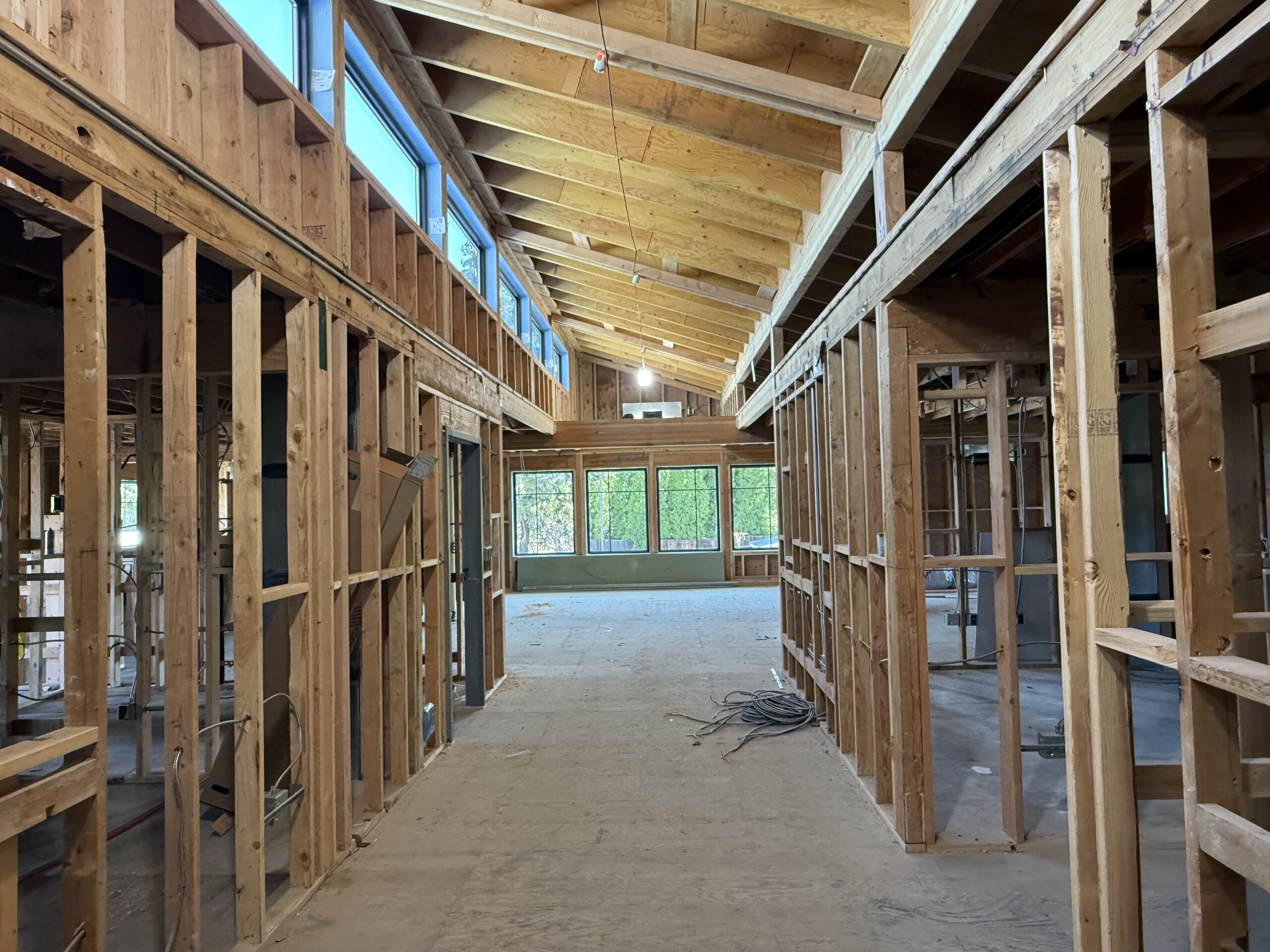

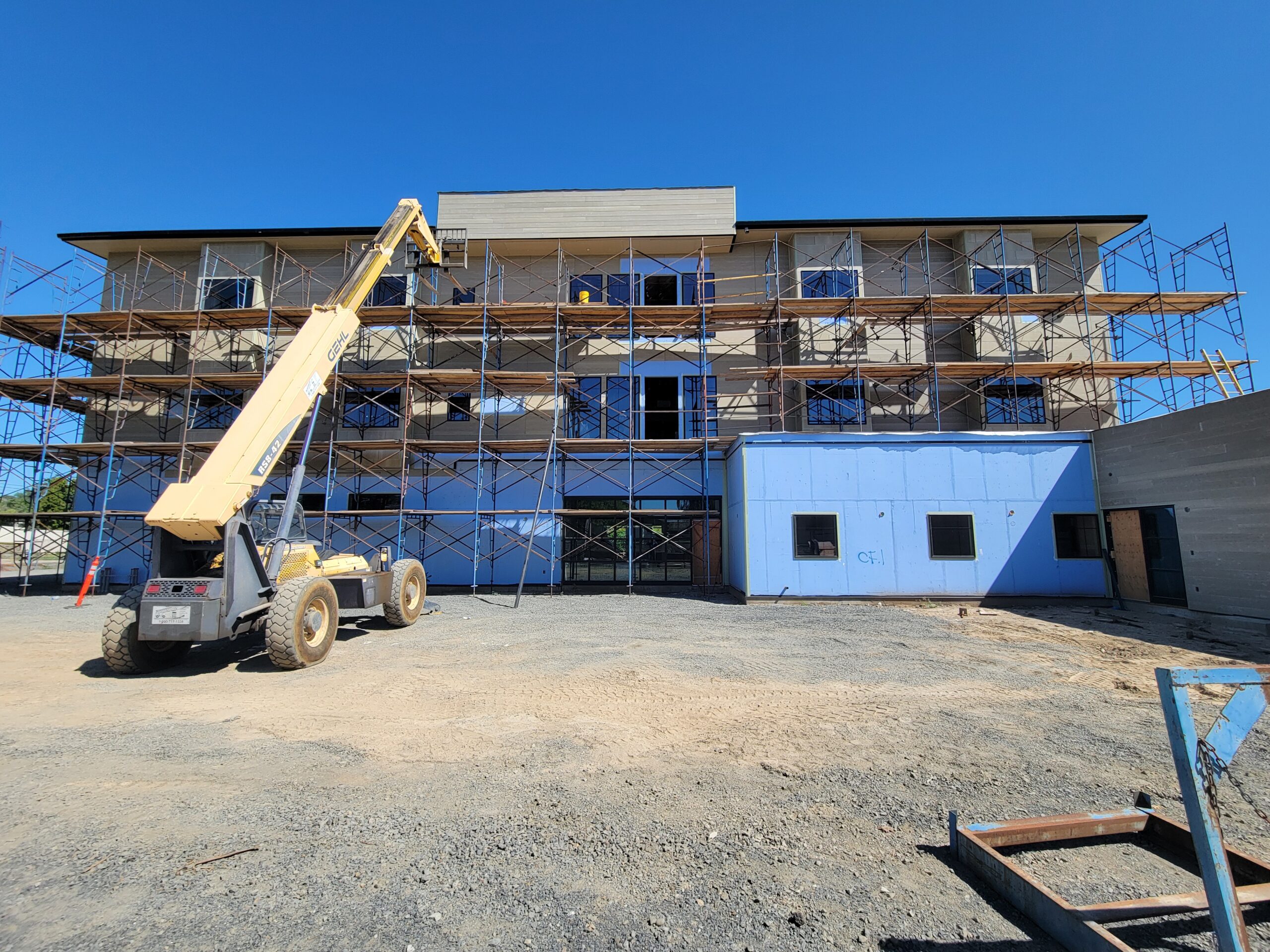

Construction has been progressing on schedule and at a rapid pace so far in May, most days 4-5 subcontractors are onsite erecting siding, drywall, and interior utilities. Pictured the North siding is nearly completion and the main corridor with drywall installed.

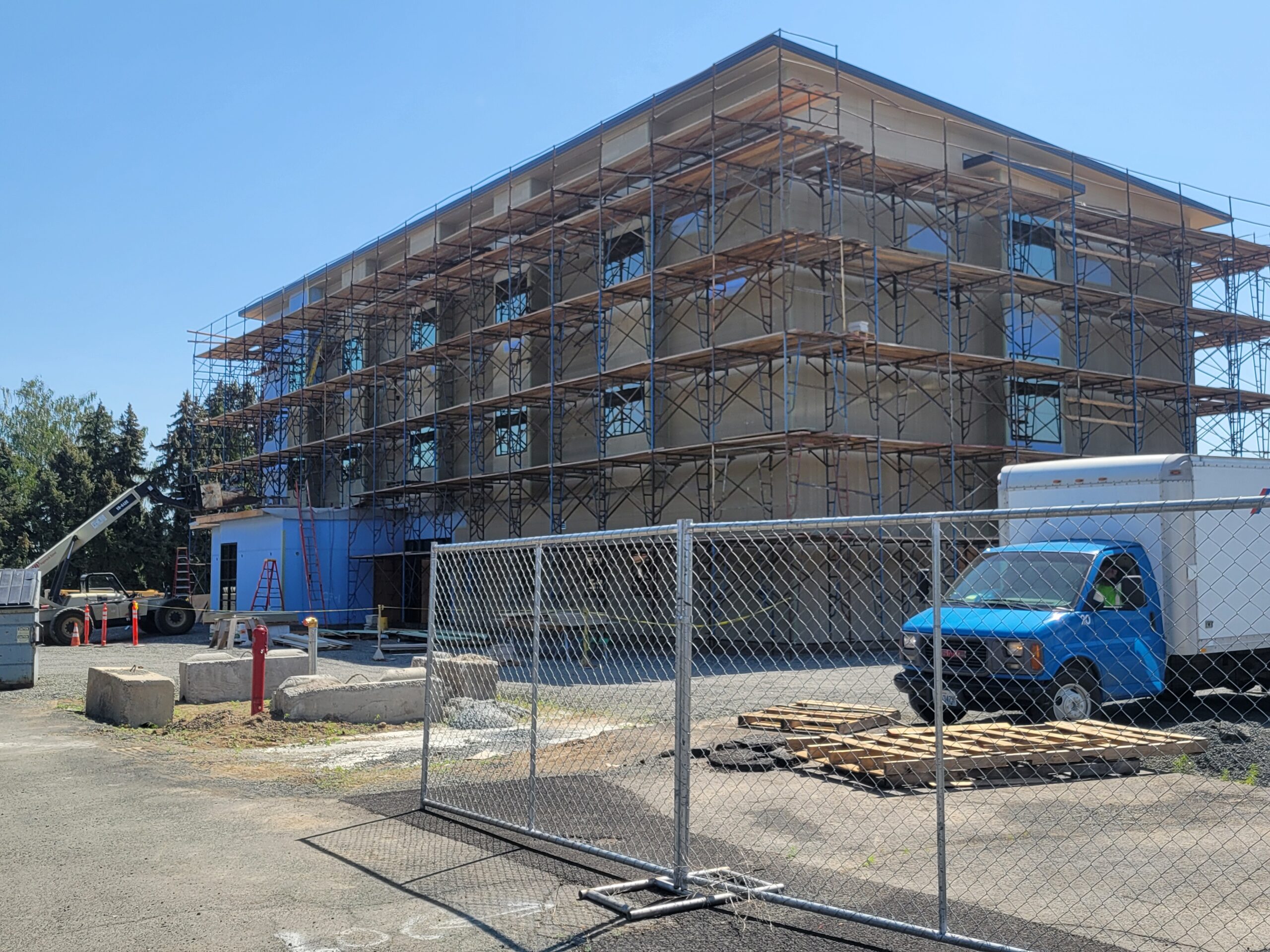

May 2nd 2025,

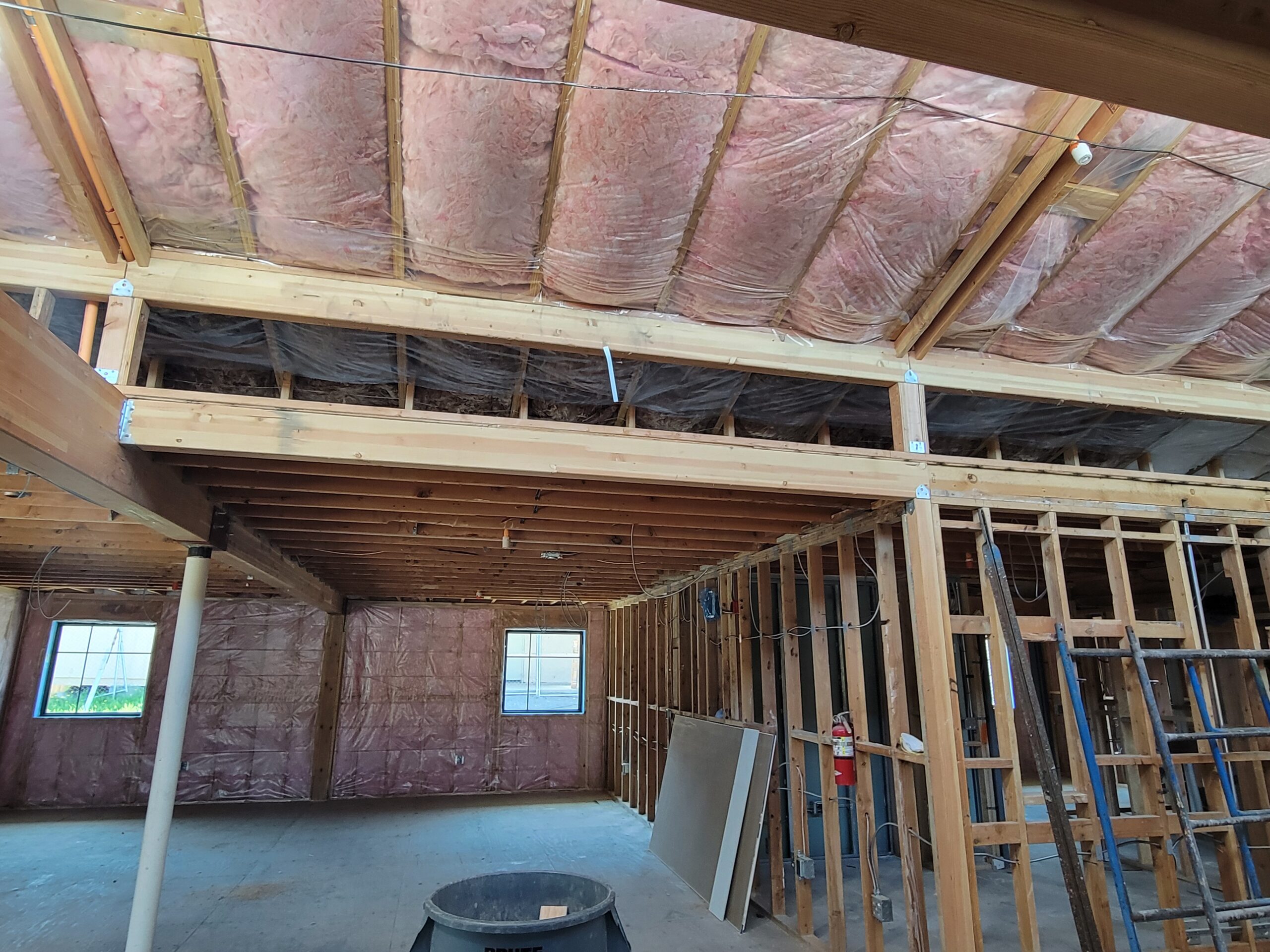

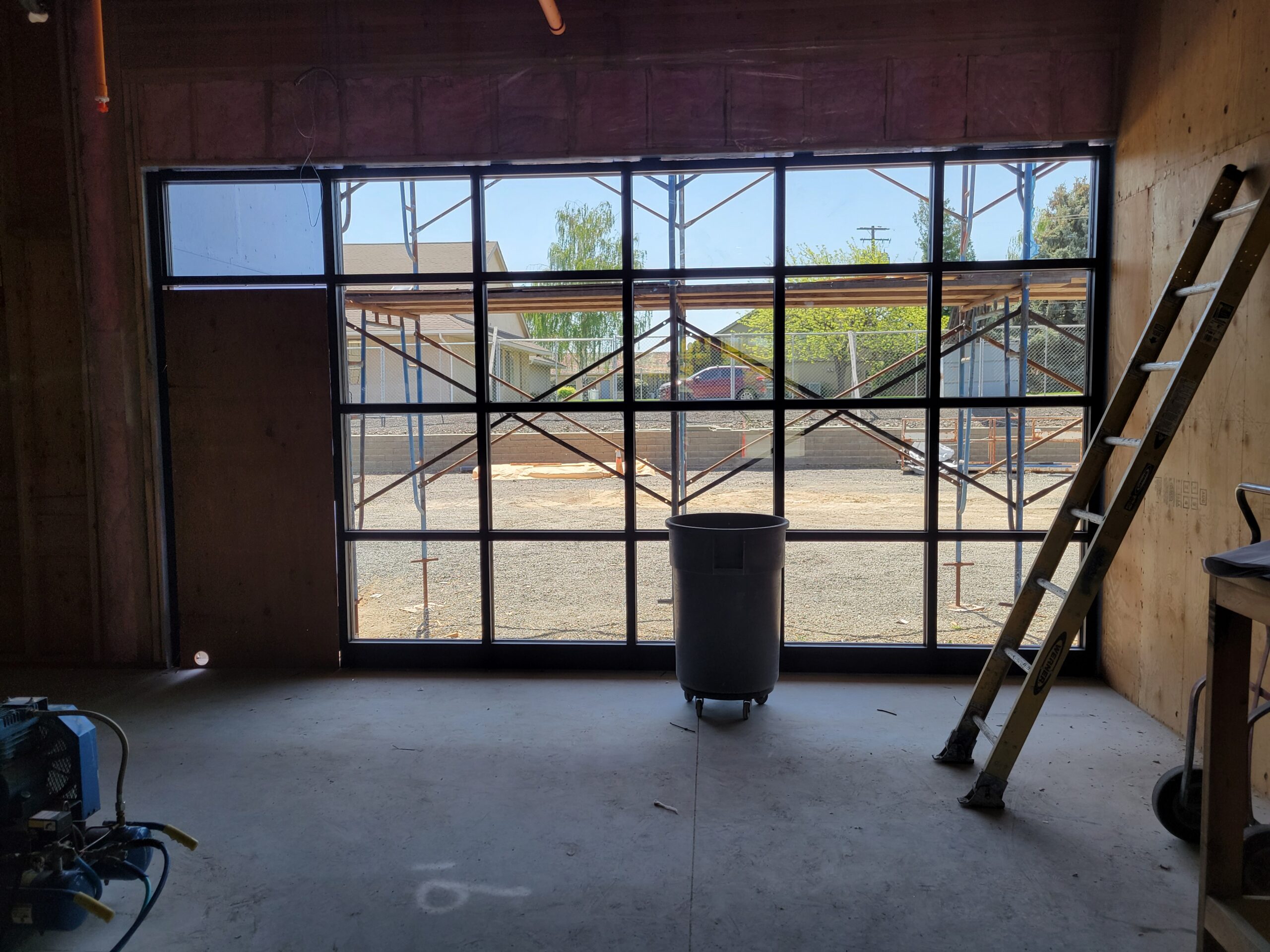

Utility rough in has continued to progress on the interior of the building and all of the first floor has passed inspection. Insulation has been installed, and drywall begins the week of May 5th to close up the walls. Additional site soil testing will begin in May in addition to exterior siding which is moving along on schedule.

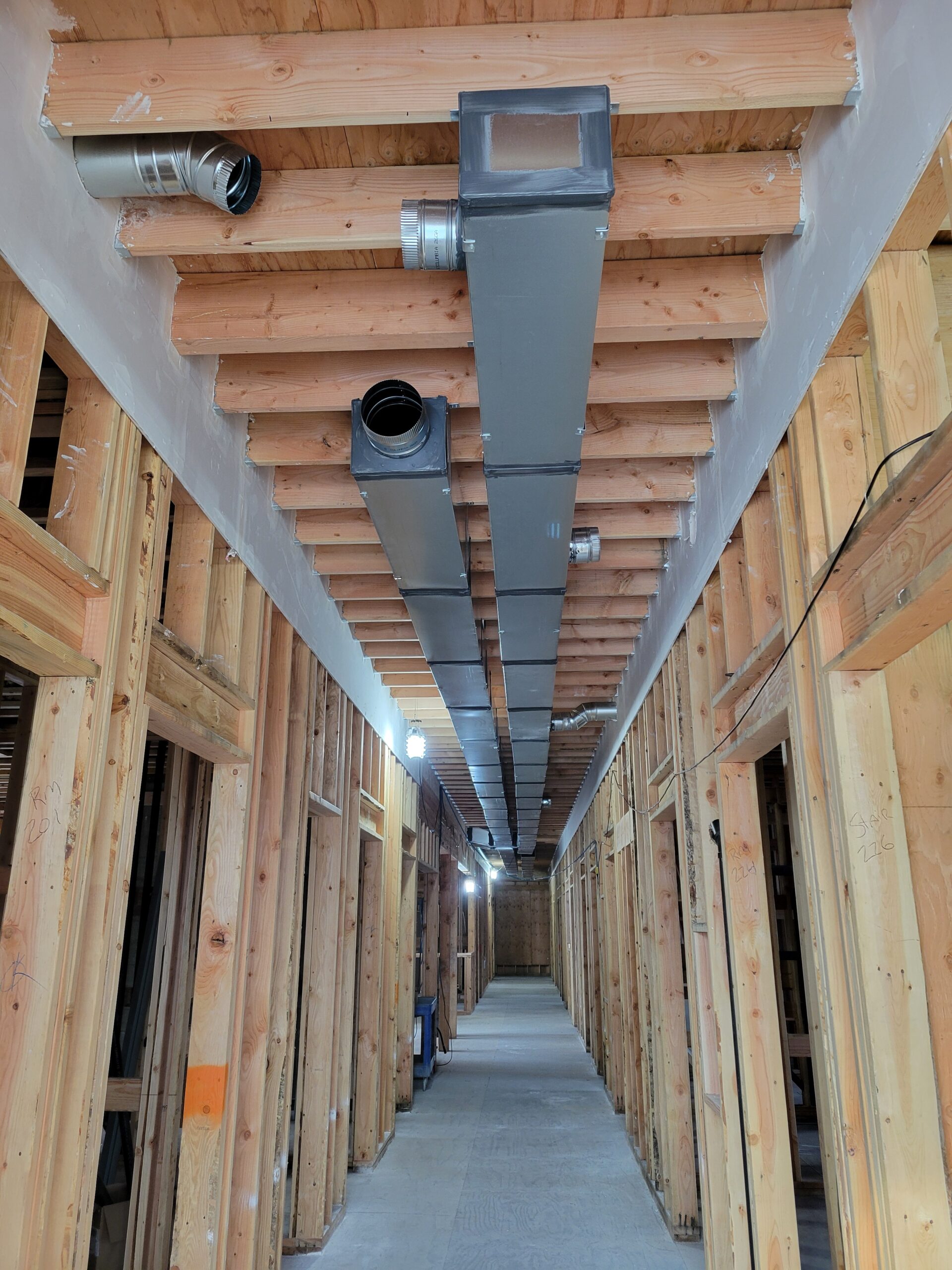

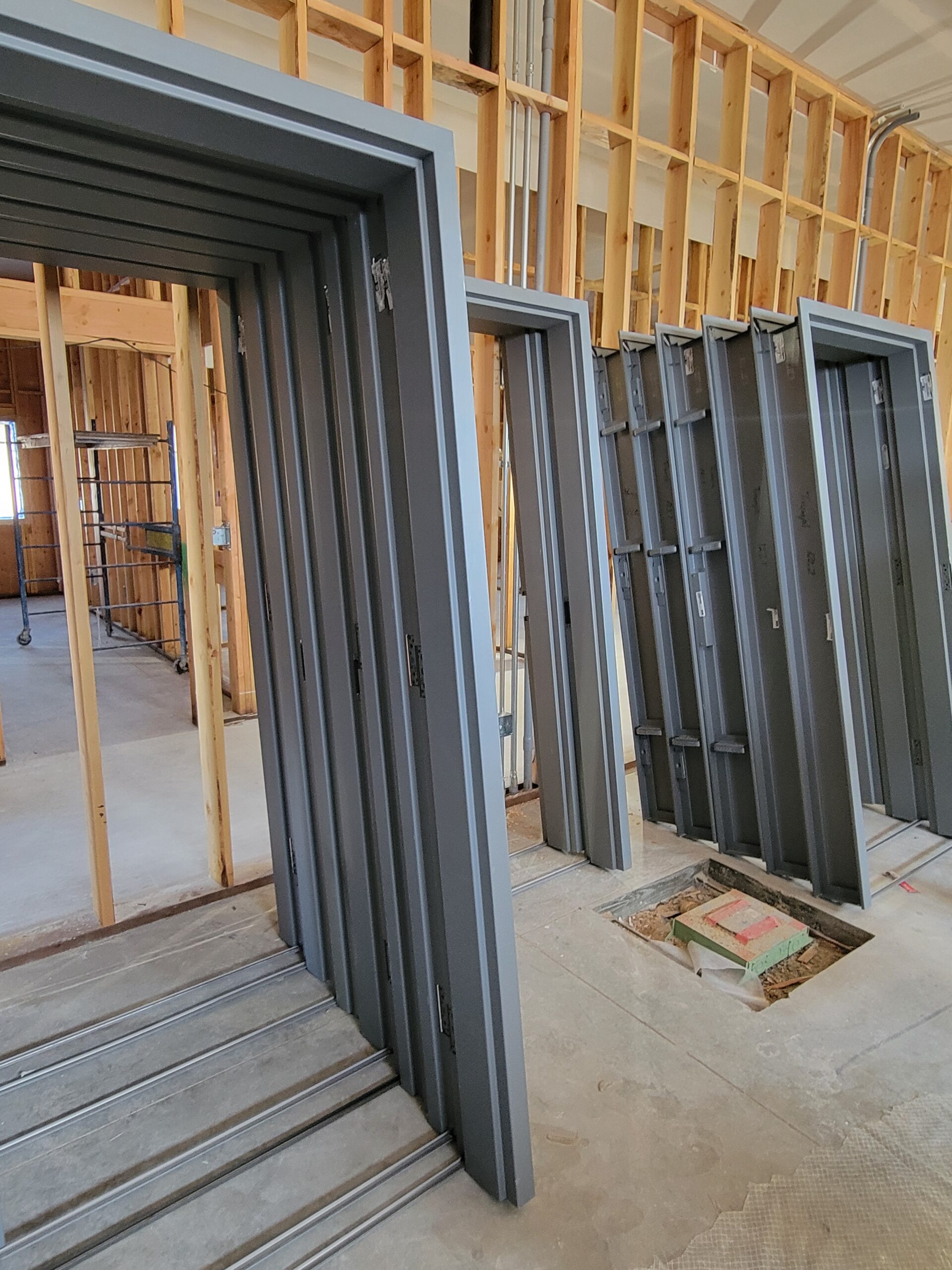

March 19th 2025,

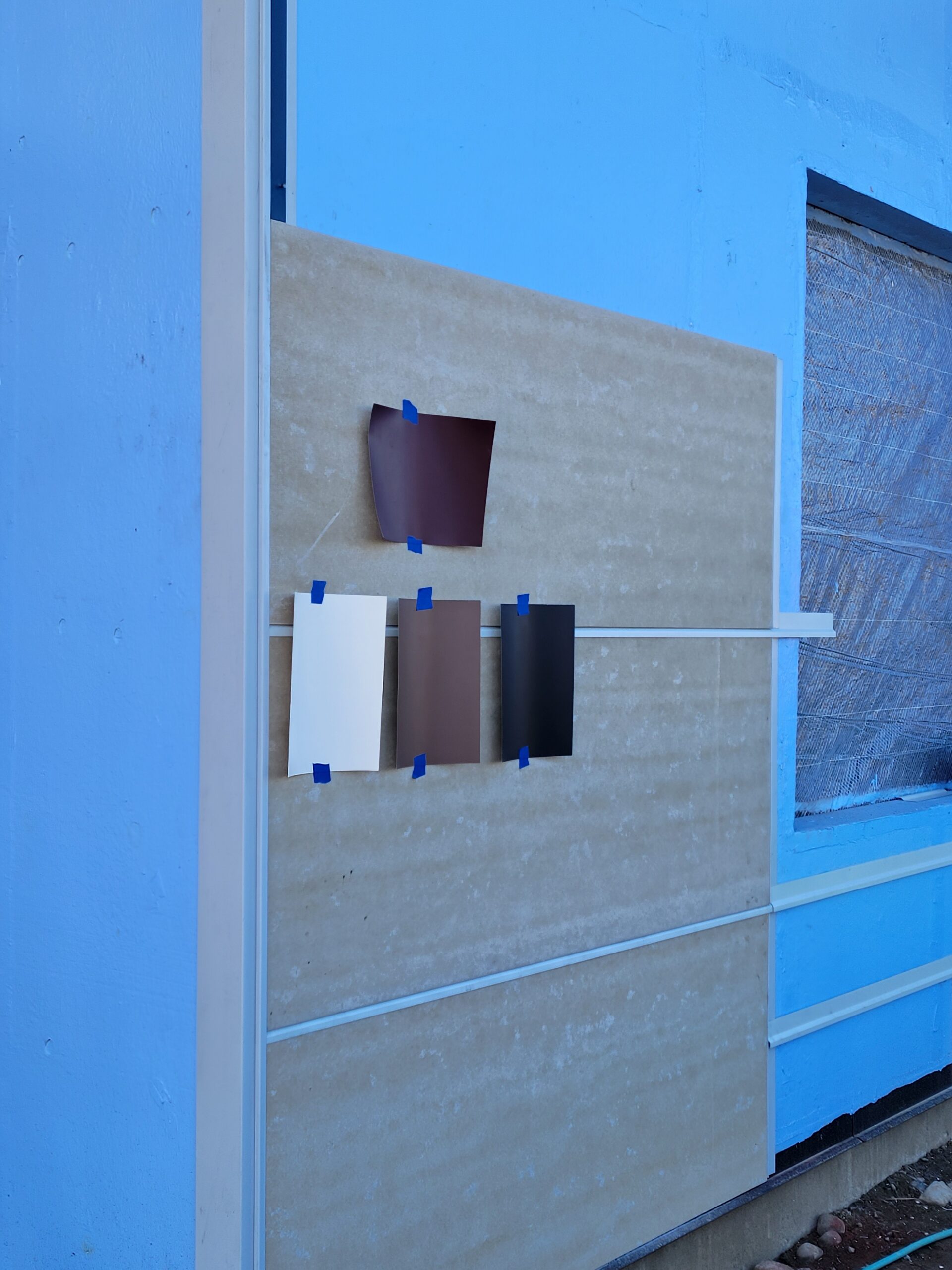

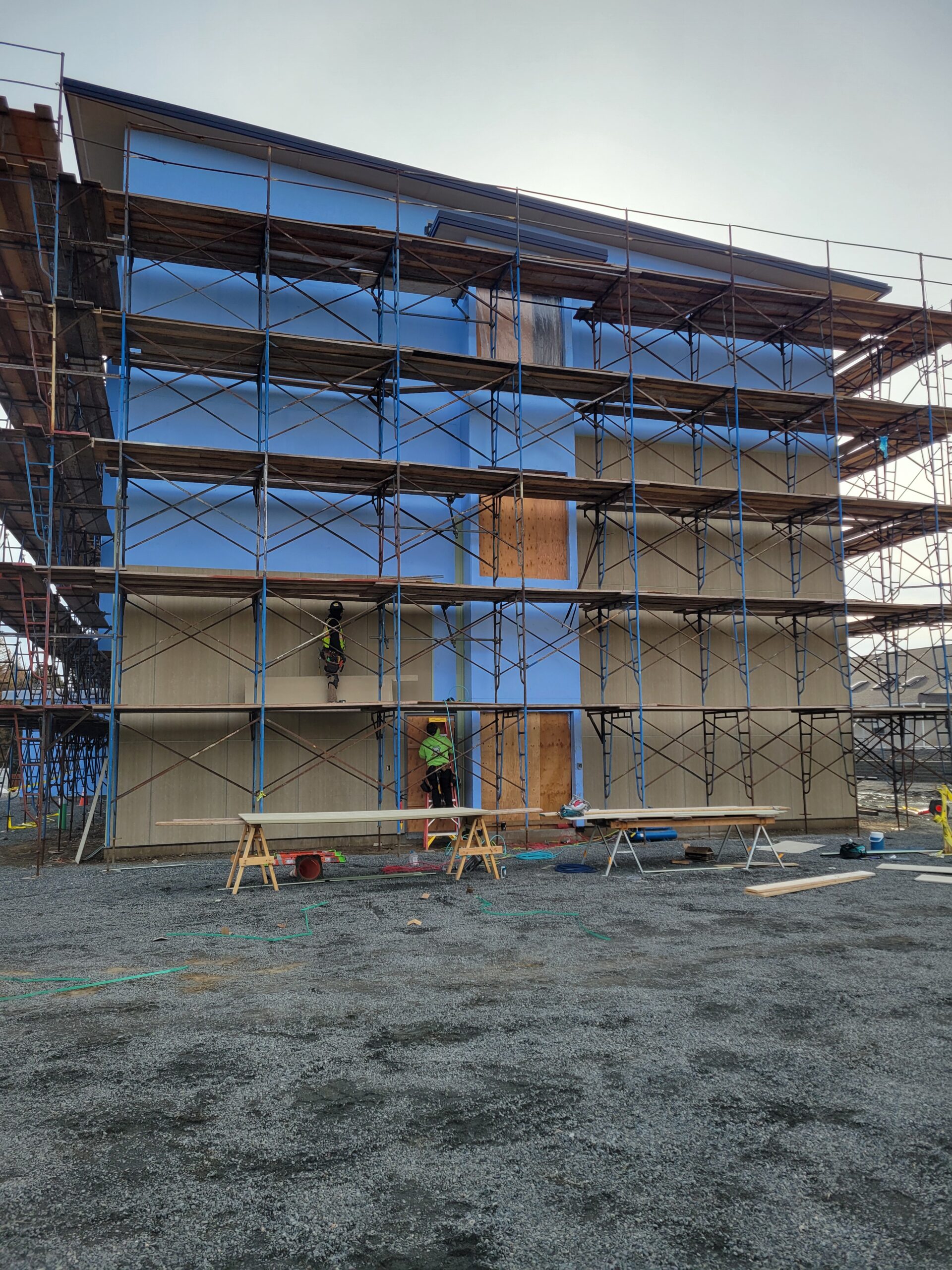

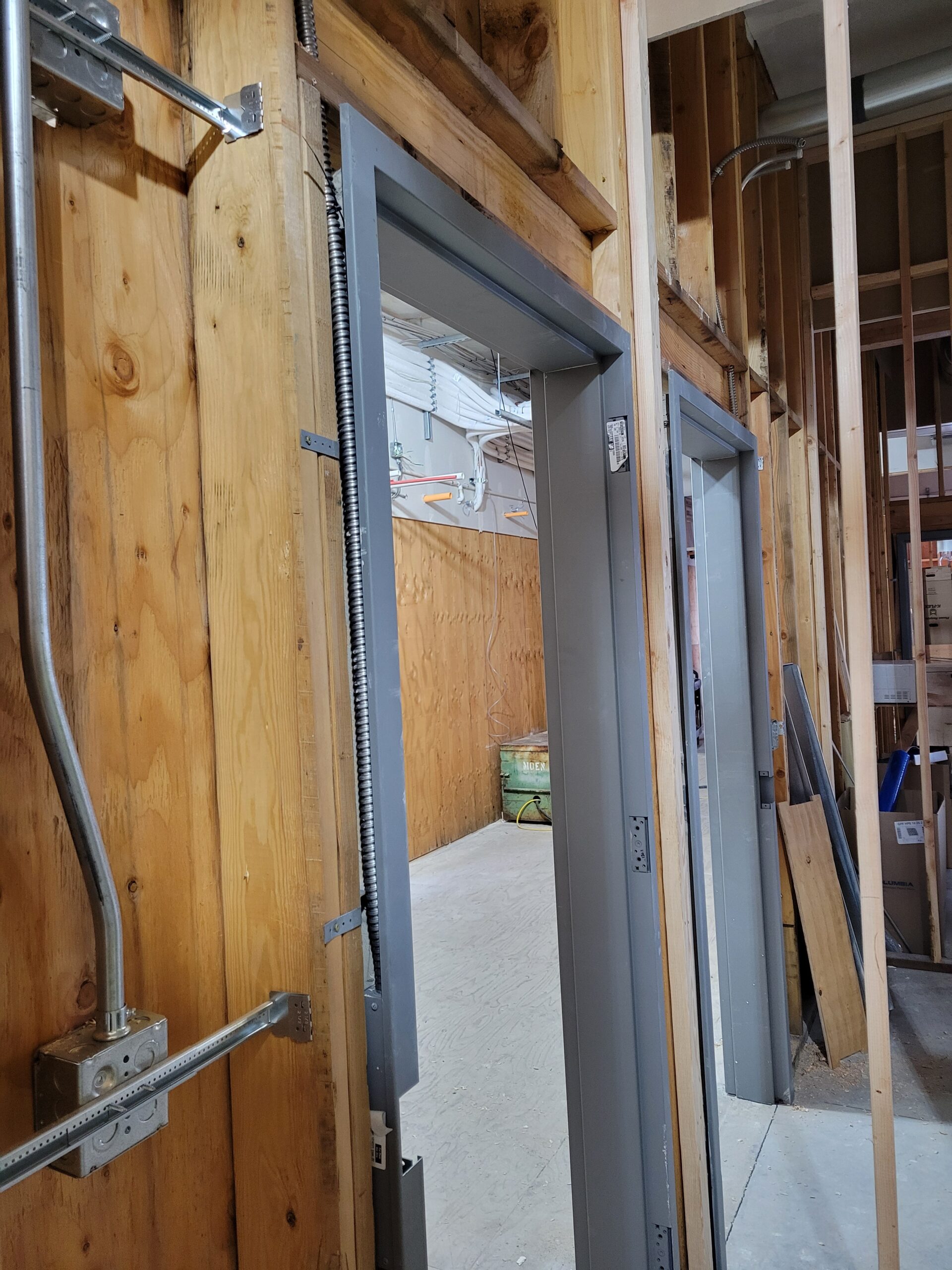

Door jams arrived and were installed and wired for card access. Siding material has been selected and is being installed on the building exterior however color selection is still taking place. HVAC ductwork continues to be installed and is now on the 2nd and 3rd residential floors. Electrical subpanels are also placed for continued electrical work.

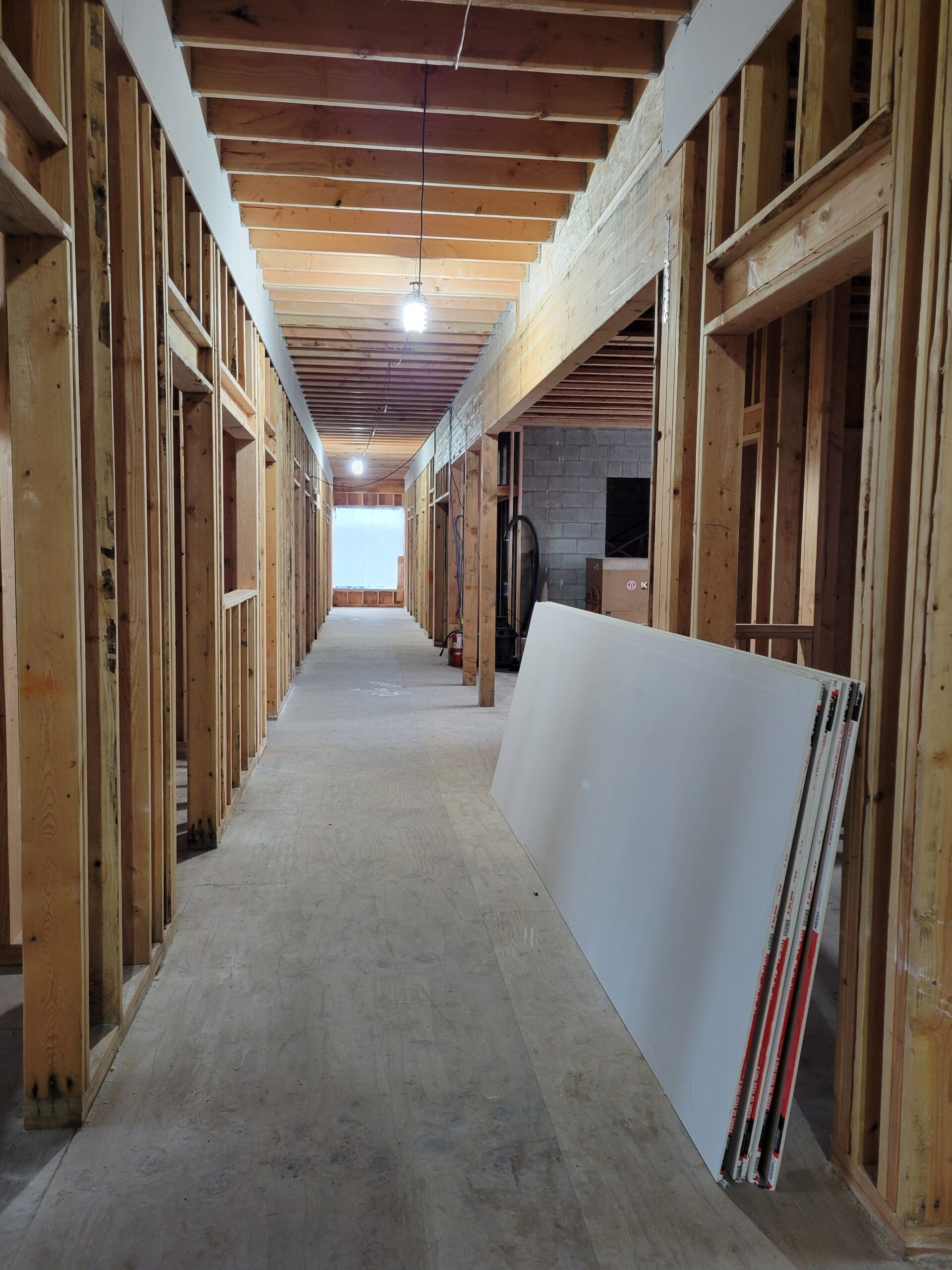

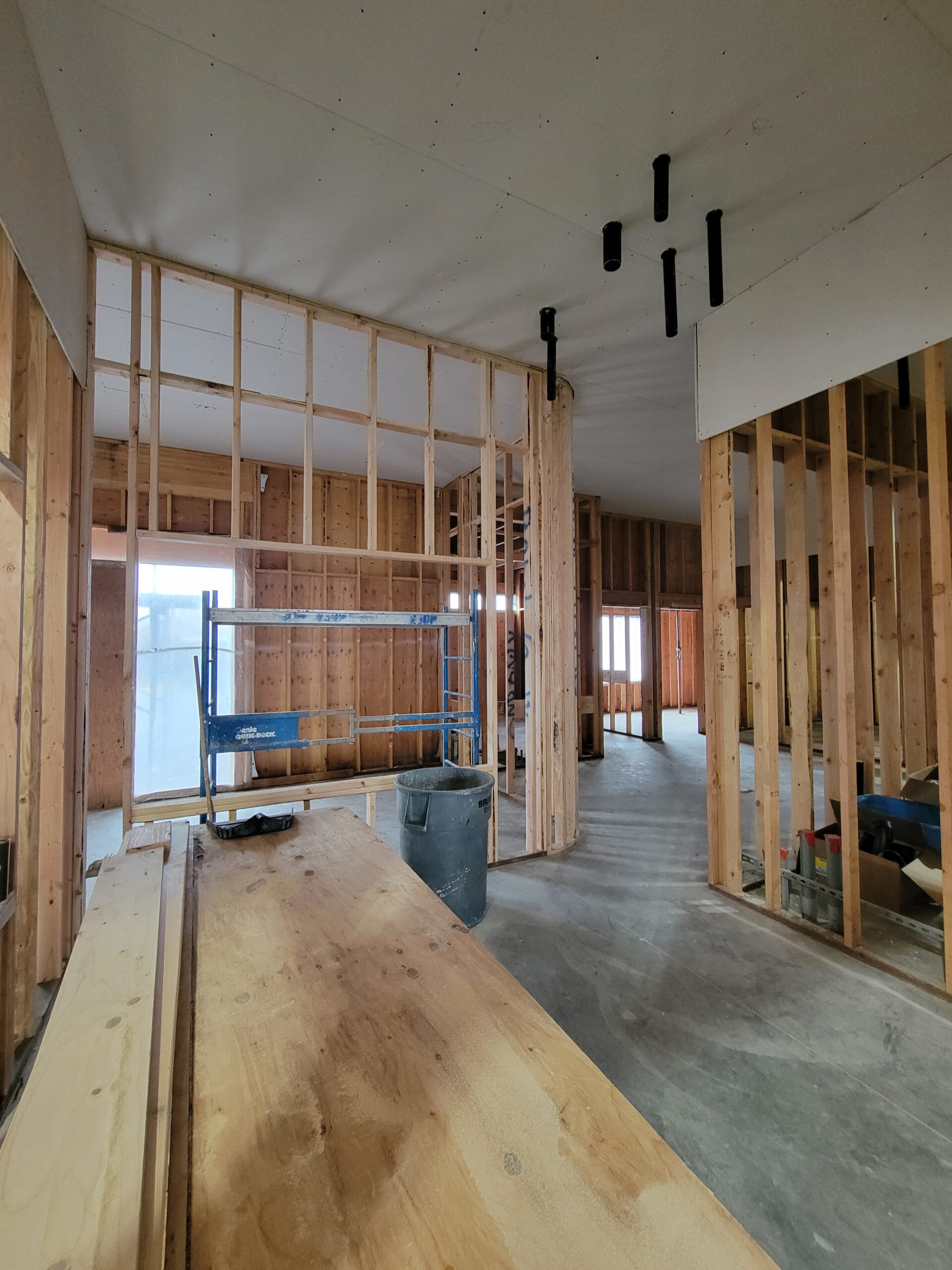

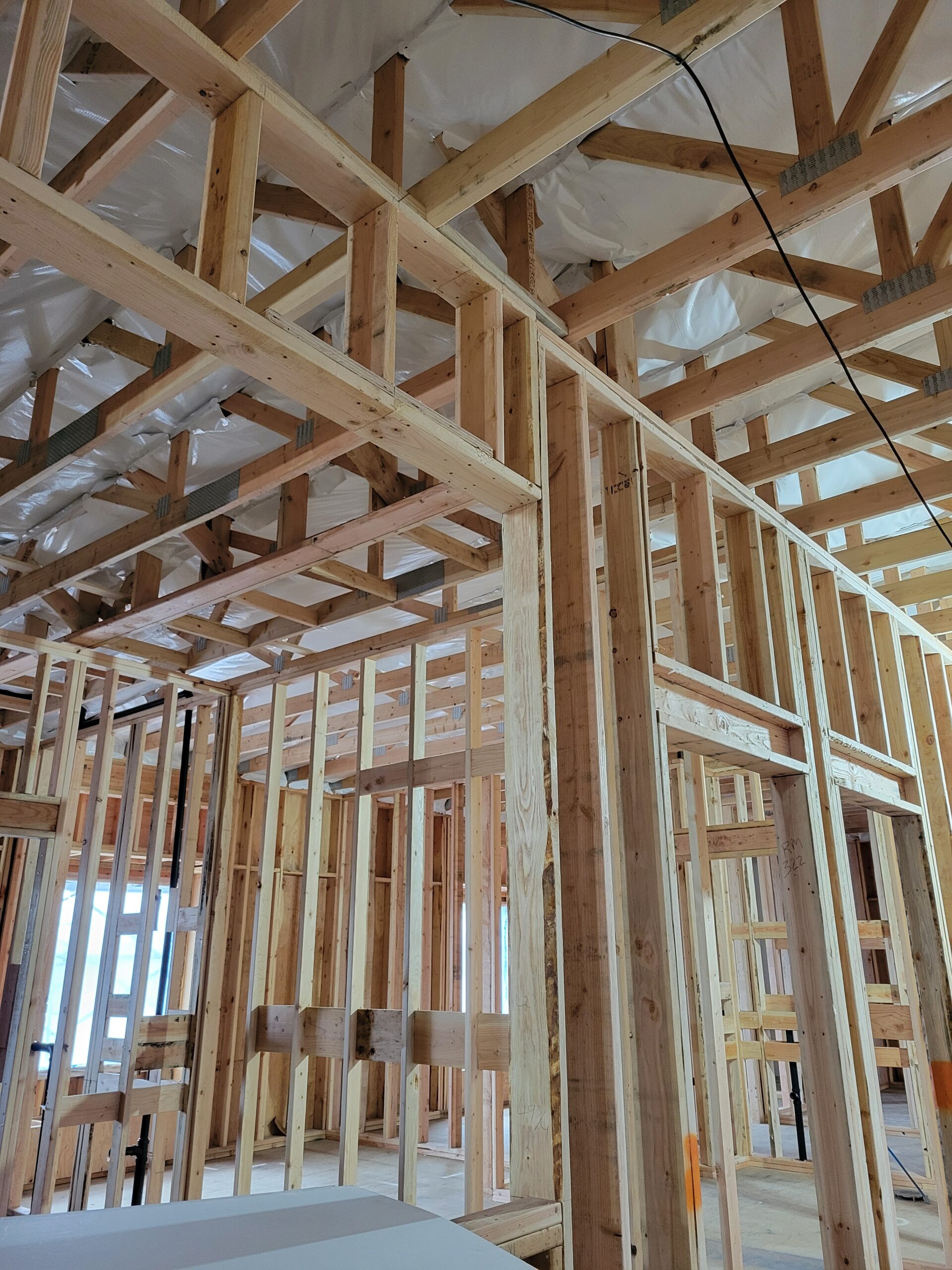

Feb 25th 2025,
Interior utility work has continued and been focused on the East end of the building. Pictured are the electrical and data boxes, plumbing lines, and HVAC refrigerant lines. Insulation has been added to the ceilings and drywall work continues in areas as appropriate.

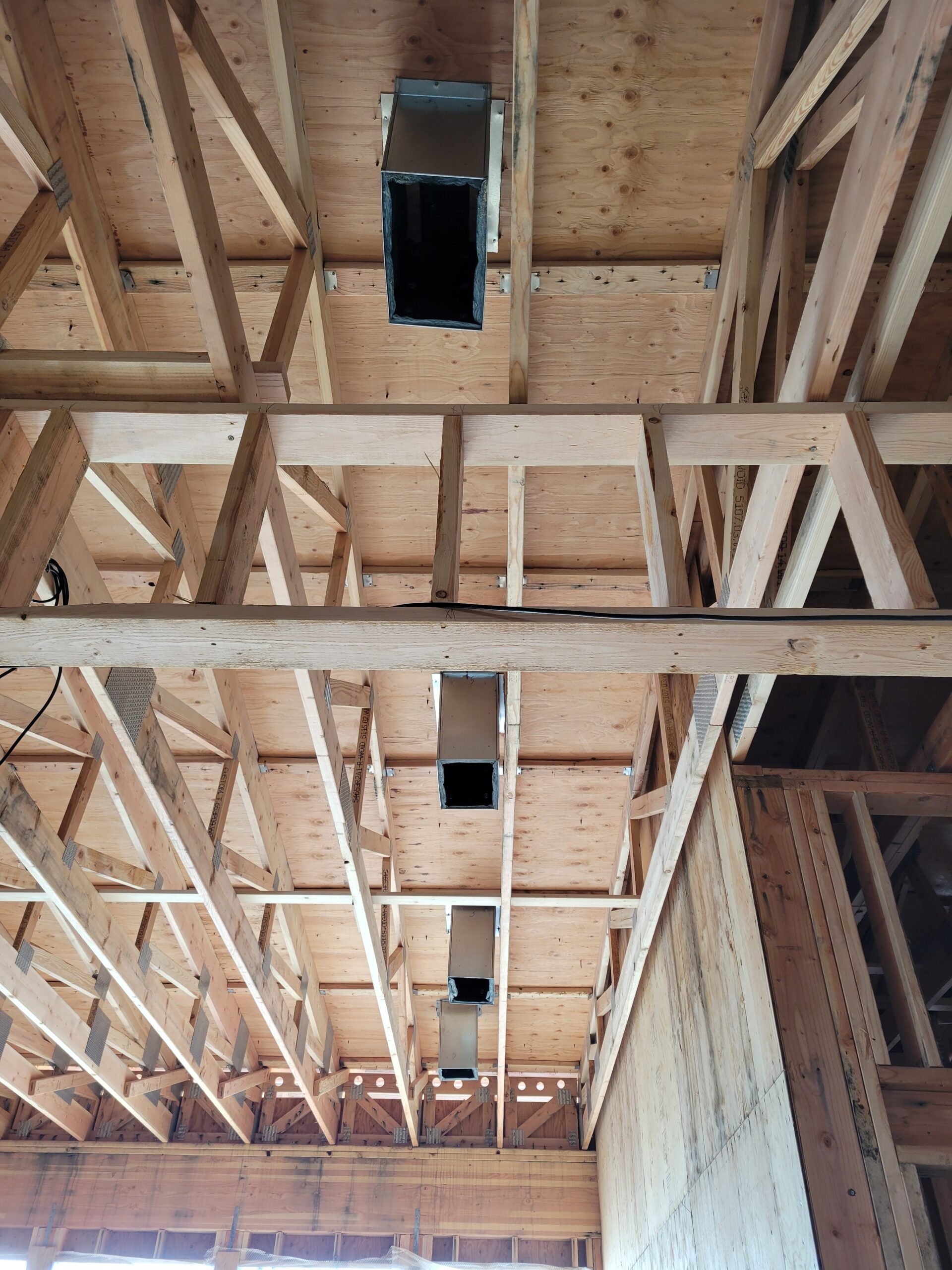

Feb 10th 2025,

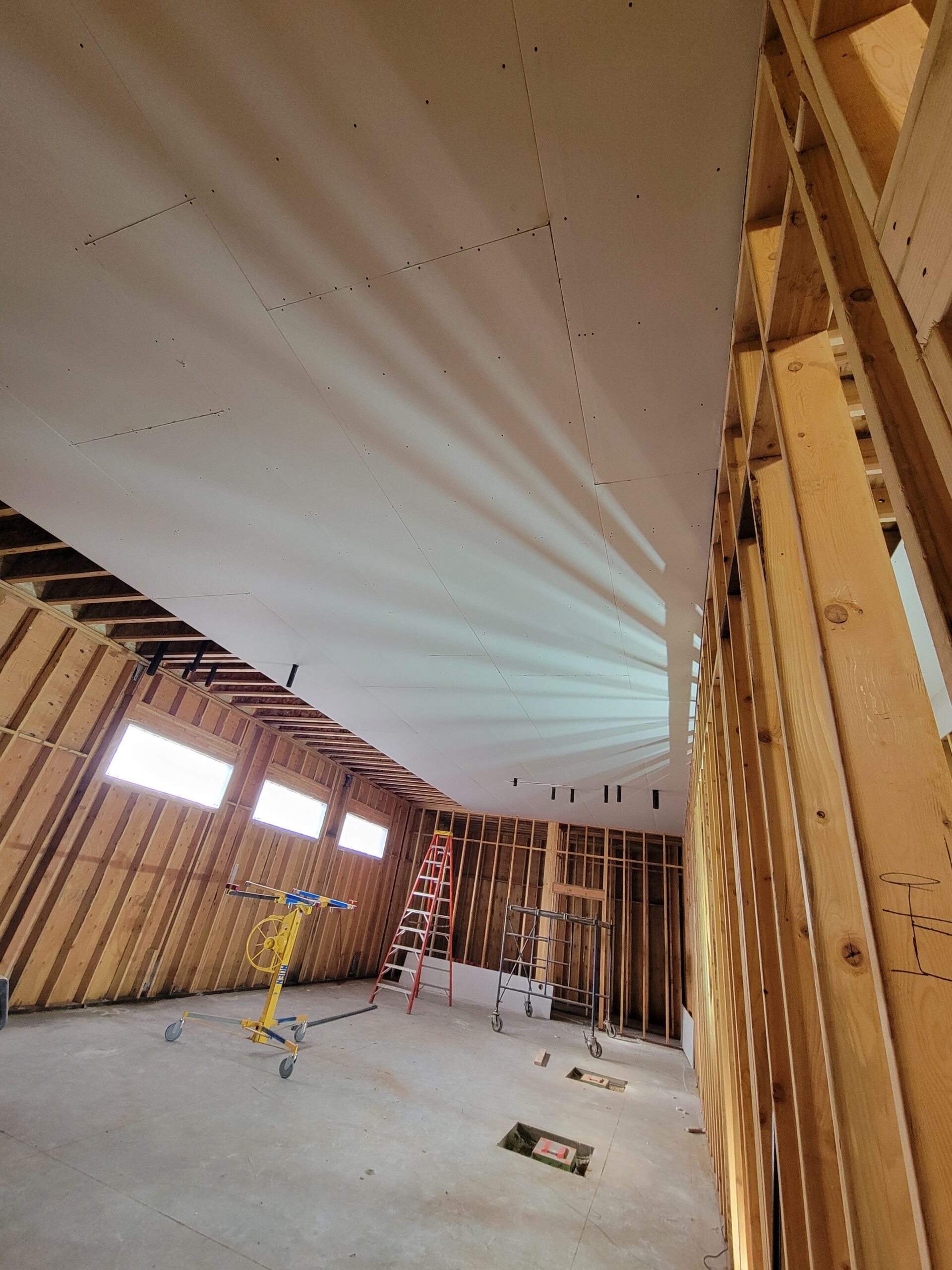

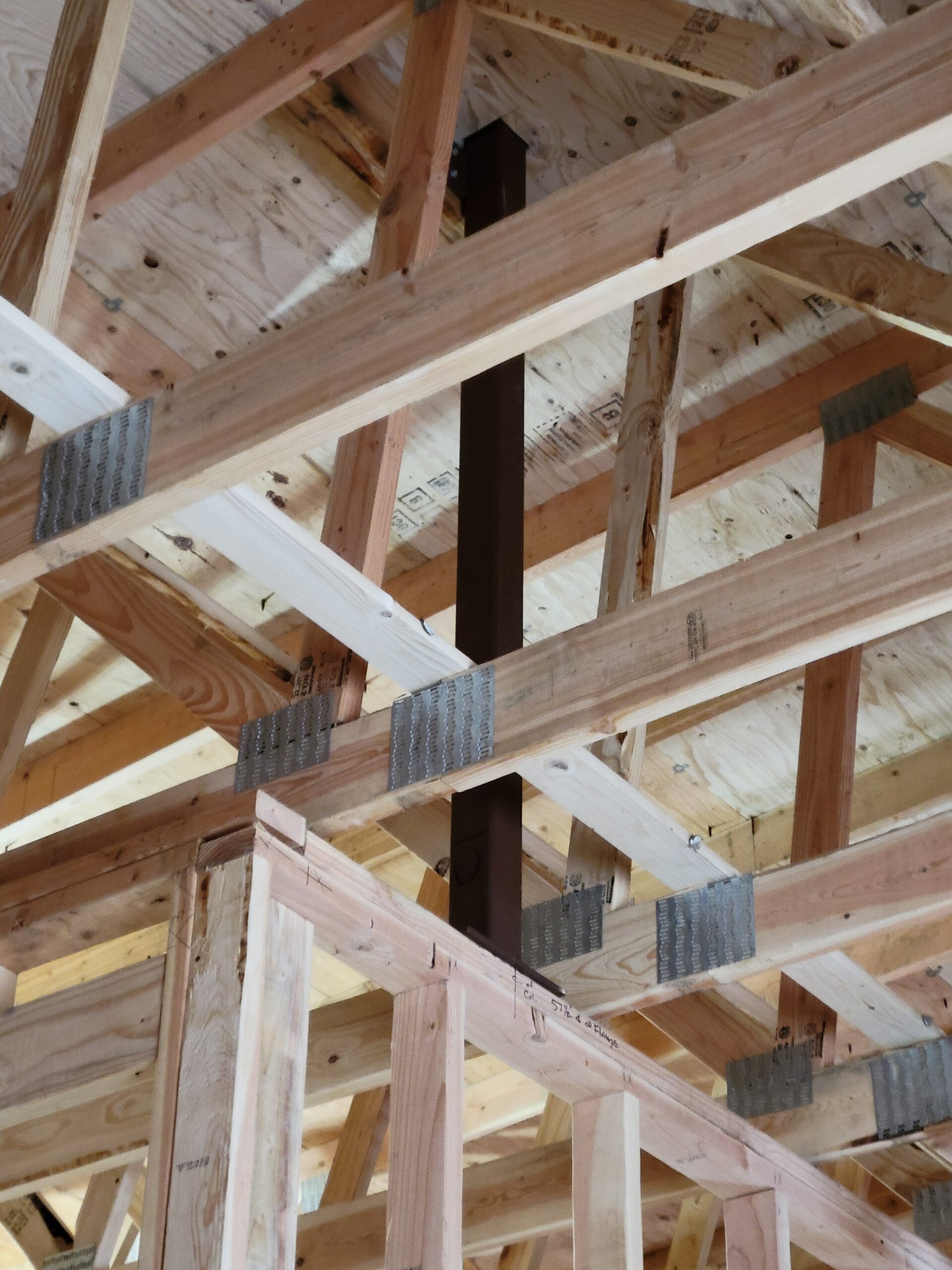

The building envelope was completed, meaning the exterior was sealed up so heat could be added to the building for dry in and more comfortable working conditions for the crews. Plumbing and electrical rough in continues and where appropriate, drywall is being installed in the hard ceilings. Roof ductwork for HVAC has been started as well as structural supports for the North exterior design feature.

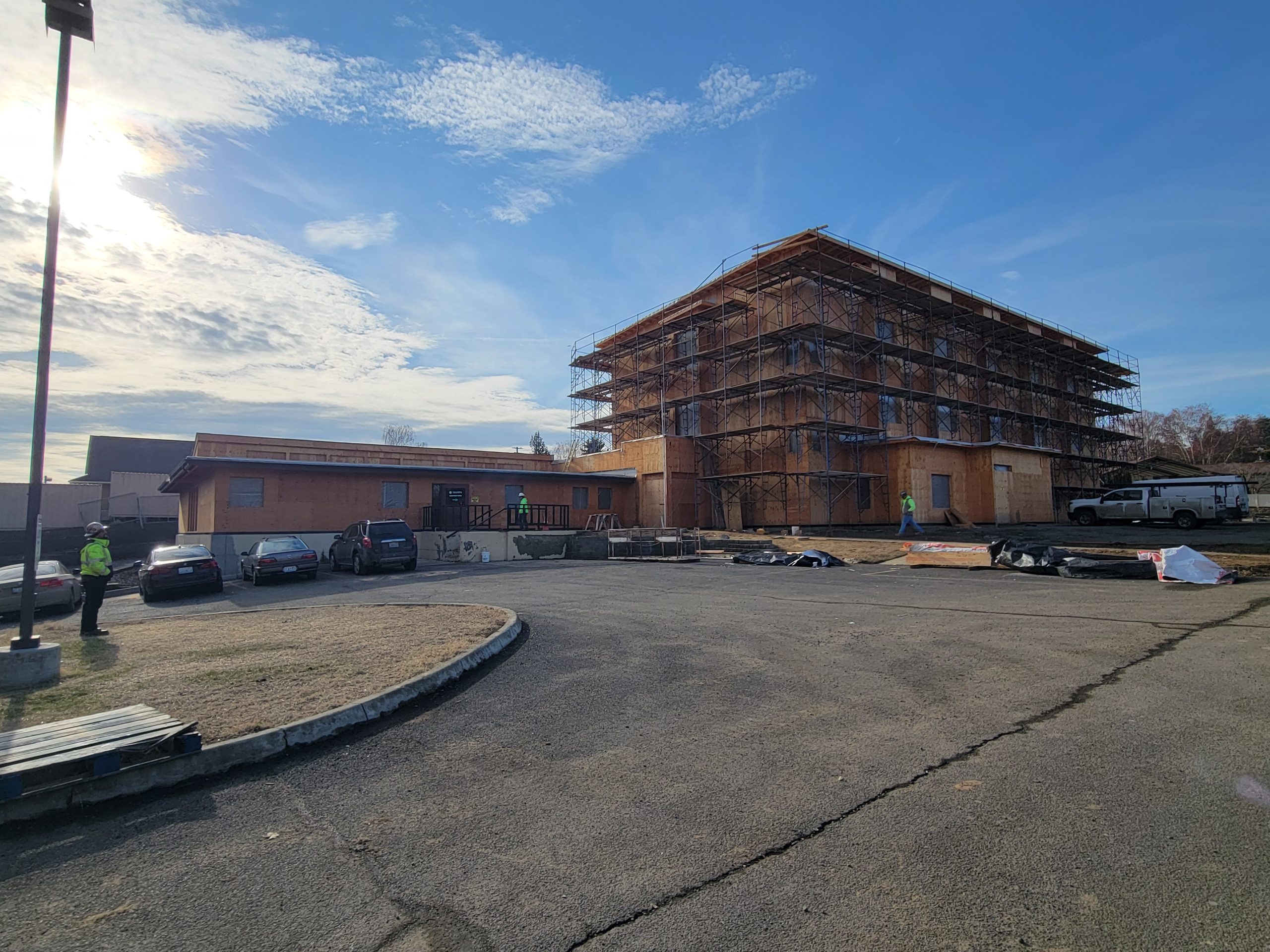

Jan 27th 2025,
The rendering below shows off the new design and function of the medical suite at Inspirations. This will allow for the growth and expansion of integrated care treatment modalities to best accommodate Triumph’s clients in the future. This includes managing withdrawals, mental health issues, and medical concerns on our premises so that clients can receive top-quality treatment without needing to leave.

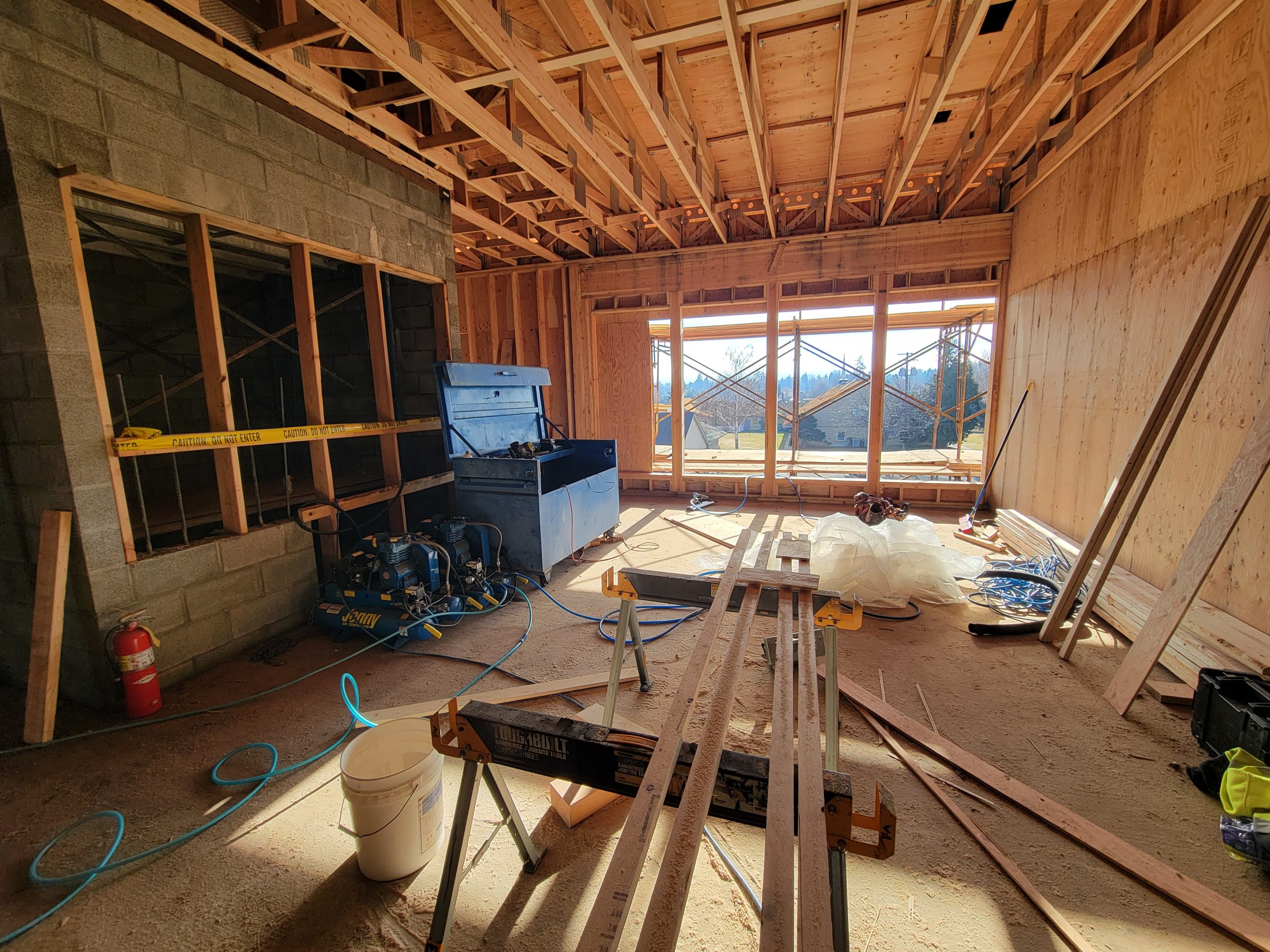

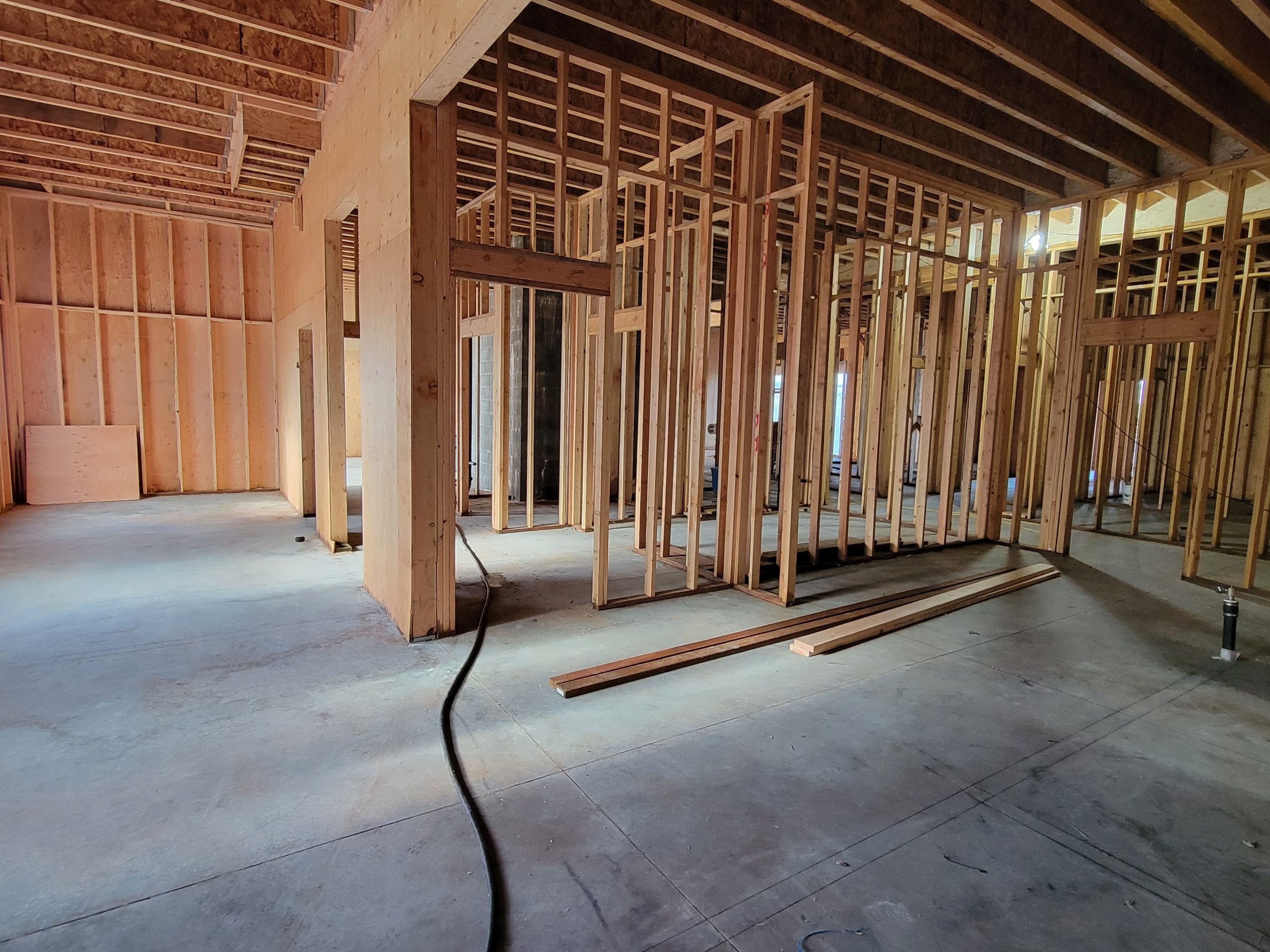

Jan 14th 2025,
Early 2025 provided the time and materials to finish framing in the building as well as putting the trusses, sheeting, and roof up. GH Moen is focused on sealing up the building and rough in of plumbing lines has begun. Electrical rough in will take place at the end of the month in addition to instillation of windows and doors in the near future.
Jan 1st 2025,
Work has been focused on finishing the framing of the third floor which contains dormitory rooms for 16 clients. Trusses were installed the week of December 23rd and the roof will be installed to dry in the building the week of January 6th, 2025.
October 31st 2024,
Renderings were completed highlighting the exterior and interior structures and design of the new Inspirations Building. Designs are subject to change.
October 24th 2024,
The first floor has been framed out and the expected completion of the second floor framing is expected to be mid-November; GH Moen Construction crew is framing a floor every three weeks. In mid-December, the third floor will be framed out and construction of the roof to seal the building will begin.
September 25th 2024,
Eleven concrete mixer trucks brought in the 110 yards of concrete to pour the 5” deep slab for the Inspirations new build. Expansion joints will be cut into the slab within the next 48 hours, immediately followed by framing and walls going up. Pictured, the finish work for the slab and all utility conduits for the respective treatment and resident rooms are visible through the concrete.
September 19th 2024,
Construction continues…
August 20th 2024,
Construction continues…
July 20th 2024,
Construction continues with the abated and framed “renovated” section of the Inspirations building. New footings and crawl space started.
July 10th 2024,
Contstruction continues as the foundation work for Inpsirations starts…
June 12th 2024,
On June 12 at 11:30am Triumph Treatment Services (Triumph) held a groundbreaking ceremony themed “Recovery Rocks” which launched the Inspirations’ expansion. The project was supported by several community partners and legislators across the state including Senator Curtis King, Representative Gina Mosbrucker, and Representative Chris Corry. Unable to attend the event, Representative Corry sent the following remarks: “I am extremely proud to be working with Triumph Treatment Services as they strive to support our community with crucial substance use and mental health treatment. Triumph has been an outstanding community partner, and I was honored to be able to assist them with this expansion. It is vital that people in our community have access to world class treatment close to home. Thank you to the various community partners that have made today possible and thank you Triumph for your commitment to serving our valley.”
Senator Curtis King was able to attend and shared his enthusiasm with the crowd: “They (the staff at Triumph) do great work…. They make a difference in individual lives and families. That’s why we’re here, that’s why this is important, and that’s why the funding came from the state.”
Several colorful rocks (painted by past clients) with hopeful sayings such as “trust the process” were on display at the event. Chanelle Surginer shared her recovery story and said, “In my stay at Inspirations, my brain had the chance to begin the healing process… Inspirations was the rock that my recovery was built on, and I am happy to say that last month I celebrated three years clean.”

May 9th 2024,
Triumph received permits to begin the demolition of the existing Inspirations structure. Crews from local companies GH Moen and Tri-Valley Construction were successful in partially demolishing the building, protecting a portion that will undergo renovations. Crews have been working to clear and clean the ground so that site preparations for building can begin.
